American Airlines and Dallas Fort Worth International Airport have officially opened the new Terminal C pier, unveiling nine state-of-the-art electronic boarding gates at what is already the busiest terminal at one of the world’s most active aviation hubs. The pier is the first tangible output of the approximately $3 billion Terminal C reconstruction and expansion programme, itself the flagship component of DFW’s overarching DFW Forward capital plan totalling nearly $9 billion in airport-wide investments. Four of the nine gates represent net new capacity, while five are rebuilt replacements, all delivered within a 115,000 square foot pier structure constructed over two years using an offsite modular technique. Six megastructure modules, with the largest measuring 204 feet by 68 feet and weighing approximately 1,200 tons, were fabricated away from the operational terminal and transported across two closed runways overnight using self-propelled modular transporters in April 2024. The approach was chosen specifically to minimise disruption to a terminal averaging nearly 200 departures per day during construction. Beyond the gates themselves, the pier introduces energy-efficient dynamic glass windows, elevated ceilings, new concessions and restrooms, and the debut at scale of dormakaba electronic boarding gates, making American Airlines the first U.S. carrier to deploy the technology across a major hub.
America’s Airport Infrastructure Wave and the Case for Building Smarter
The Terminal C pier opening places DFW at the visible edge of a broad renewal cycle sweeping through the United States’ ageing airport estate, with the modular construction method it has pioneered serving as an increasingly influential template for other constrained live-operation environments. Terminal C, which is 52 years old, handles the load of what would independently rank as the fifth largest hub in American’s network by mainline departures, and its transformation spans three sequential reconstruction phases ultimately delivering 32 gates across more than one million square feet. The modular approach now extends beyond Terminal C: a parallel pier expansion at Terminal A will open later in 2026 with 10 gates, and American Airlines has committed $4 billion to the entirely new Terminal F, whose first phase of 15 gates is targeted for 2027. That pipeline positions DFW alongside the most aggressive terminal investment programmes currently underway anywhere in the country. The pace of renewal is not unique to Texas: Cleveland Hopkins International Airport is advancing a $1.6 billion terminal overhaul under the CLEvolution programme, similarly relocating the landside terminal to reduce construction disruption while delivering a facility designed to serve the airport through 2032 and beyond. What distinguishes the DFW programme is scale and integration: rather than standalone terminal replacement, DFW is simultaneously reconstructing a legacy terminal, adding a new one, expanding two others, and rebuilding associated parking infrastructure as a single coordinated multi-decade effort.

Project Fact Sheet
- Project Name: DFW Terminal C Pier Expansion and Gate Modernisation (Phase 1 of Terminal C Reconstruction)
- Location: Dallas Fort Worth International Airport, Fort Worth, Texas, United States
- Project Value: Approximately US$3 billion (Terminal C full reconstruction programme); part of US$9 billion DFW Forward capital plan
- Client / Owner: Dallas Fort Worth International Airport in partnership with American Airlines
- Main Contractor: Joint venture of Austin Commercial, Azteca Enterprises, and Alpha and Omega
- Architect / Designer: HOK and Muller and Muller Ltd.
- Programme Manager: HNTB, KAI Enterprises, and ADPI

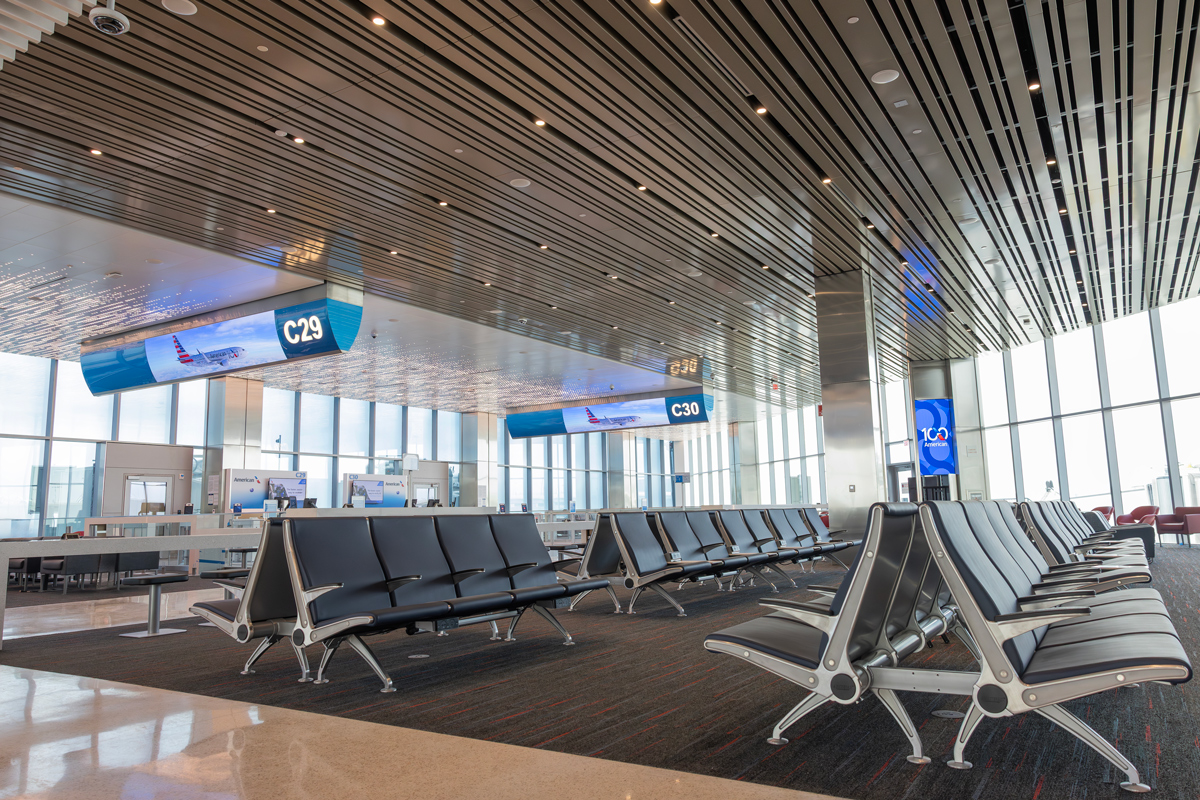

- Key Components: 9 electronic boarding gates (4 net-new, 5 rebuilt); 115,000 sq ft pier; dormakaba gate technology; new concessions, restrooms, and seating; adjacent south parking garage reconstruction

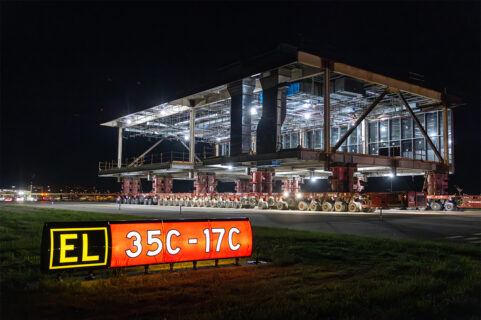

- Construction Method: Offsite modular fabrication; 6 megastructure modules transported by self-propelled modular transporters across closed runways
- Pier Completion / Opening: June 8, 2026
- Full Terminal C Completion: Expected by approximately 2030 across three phases; ultimate build-out of 32 gates and more than 1 million square feet
- Strategic Impact: First U.S. airline to deploy electronic boarding gates at scale; anchors DFW’s position as the centrepiece of a $9 billion national hub transformation

Project Team
- Dallas Fort Worth International Airport — Airport Owner and Programme Lead
- American Airlines — Anchor Airline Tenant and Joint Programme Partner
- Austin Commercial — Lead Design-Build Contractor (JV)
- Azteca Enterprises — Design-Build Contractor (JV)
- Alpha and Omega — Design-Build Contractor (JV)
- HOK — Lead Architect and Design Team Member
- Muller and Muller Ltd. — Design Team Member
- HNTB Corporation — Programme Manager
- KAI Enterprises — Programme Manager (JV)
- ADPI — Programme Manager (JV)
- dormakaba — Electronic Boarding Gate Technology Supplier
- U.S. Federal Aviation Administration — Regulatory Authority
- Transportation Security Administration — Security Compliance Authority
