Construction Review




Great Northern Highway Bridge Upgrades Improve Safety and Capacity in Western Australia

Home » Transport » Roads » Great Northern Highway Bridge Upgrades Improve Safety and Capacity in Western Australia
Great Northern Highway Bridge Upgrades Improve Safety and Capacity in Western Australia

The Great Northern Highway bridge replacement project in the Kimberley region of Western Australia is in its post-construction operational phase, following the completion of key dual-lane bridge upgrades that have already begun delivering measurable freight and safety benefits. By 2024 through 2025, the new bridges at Tickalara Creek and Frog Hollow Creek were completed and opened to traffic, with final road alignments and approach works also finished, effectively removing long-standing single-lane problem along this important corridor.

As of 2026, focus is now shifted toward network integration and final upgrades, including the Arthur Creek bridge and broader corridor resilience works. These are also part of the state–federal investment program to modernize the Great Northern Highway.

Great Northern Highway Bridge Upgrades Improve Safety and Capacity in Western Australia
Great Northern Highway Route in Red Highlight

The upgraded sections are now enabling smoother freight flows, reduced delays, and improved flood resilience. This continues to highlight the key role the highway plays in Australia’s most important north–south logistics corridors. These corridors serve mining, agriculture, and energy supply chains and ports, including the Lumsden Point Project at Port Hedland in Western Australia.

Fact Sheet for Great Northern Highway in Australia – 2026 Update

Location: Kimberley Region, Western Australia

Project Type: Highway bridge replacement and corridor upgrade

Lead Agency: Main Roads Western Australia

Funding: Australian Government, WA Government

Scope:

  • Replacement of three single-lane bridges including Tickalara Creek, Frog Hollow Creek, and Arthur Creek
  • Construction of new dual-lane bridges
  • Associated road widening, realignment, and safety upgrades
  • Flood-resilient design with 100-year flood capacity

Project Cost: A$33 million through joint federal–state funding

Key Expected Outcomes:

  • Eliminates single-lane crossing constrains
  • Improves freight efficiency and travel time reliability
  • Enhances road safety with reduced head-on collision risk
  • Strengthens climate and flood resilience

Project Timeline

2019–2022: Planning and Funding

  • Corridor bottlenecks identified
  • Funding secured under national infrastructure programs

2023: Construction Begins

  • Works commence on three bridge replacements
  • Early works including site clearing, barrier installation, and foundation and earthworks

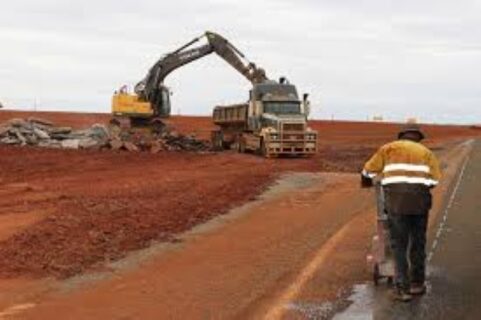

Construction works for Great Northern Highway Bridge Upgrades

2024: Major Completion Milestones

  • Tickalara Creek and Frog Hollow Creek bridges completed
  • Road alignments and approaches finalized
  • Sections opened to traffic

2025–2026: Integration and Remaining Works

  • Network integration across upgraded corridor
  • Arthur Creek bridge works and associated upgrades continue
  • Transition to full operational utilization

Know the Project’s Developer, Contractors and Stakeholders

Project Developer

Funding Partners

  • Australian Government
  • Government of Western Australia

Bridge Construction and Structural Works Contractor

  • Delivered by Fortec

Role:

  • Post-tensioned concrete bridges
  • Guide banks and flood protection
  • Approach road earthworks

Geotechnical and Piling Works Contractor

Covered:

  • Installation of 750mm bored piles into rock
  • Foundation support for all three bridges
  • Delivered in collaboration with Fortec

Survey and Spatial Engineering Contractor

Covered:

  • Bridge duplication
  • Corridor alignment
  • Earthworks and design validation

Community and Indigenous Partnership

Aboriginal businesses and workforce:

  • Over 7.5% project spend target
  • 10% employment participation target

Local Kimberley suppliers for equipment hire, labor, and logistics services

Great Northern Highway: Improving Safety and Capacity in Western Australia

Great Northern Highway in Australia: Replacement of 3 single-lane bridges with dual-lane bridges begins

Reported June 30, 2023 – On the Great Northern Highway in Australia, a project to replace three single-lane bridges with dual-lane bridges has officially begun. This project will lead to the improvement of road safety, especially in the Kimberley region.

The bridges in question cross Frog Hollow Creek, Tickalara Creek, and Arthur Creek. Alongside enhanced road safety, the project will also provide more efficiency to the freight industry that regularly depends on the highway.

In total, the bridge replacement project cost is about $33 million. A Part of its funding will be from the Federal Government, with a commitment of $26.4 million. On the other hand, the State Government is said to commit $6.6 million.

Read Also: Spoilbank Marina Project In Australia Awards Final Contract

Implementation of the Great Northern Highway Bridge Replacement Project in Australia

Initially, minor construction works began on the Tickalara Creek and Frog Hollow Creek bridges. At the moment, a recent camp has been set up at Mabel Downs Station. Alongside the involvement of several businesses and works, Fortec Australia will serve as the development contractor.

For the month of July, site fencing and installation of safety barriers as well as foundation preparation are scheduled. Additionally, road approach earthworks will be undertaken. Meanwhile, bridge works for Arthur Creek will be done during the 2024 dry season, as per an official statement.

While commenting on the project, the Federal Minister for Infrastructure, Transport, Regional Development, and Local Government noted it will serve as a major connection. Especially, between the Kimberley region and the rest of the country.

Catherine King further said that the Great Northern Highway Project represents a critical transport link for tourism, mining, agriculture, and horticulture. Furthermore, it aims to connect Aboriginal communities to a wide array of essential services.

The Western Australian Transport Minister also spoke about the project, in regards to the recent flooding within the region. Rita Saffioti placed emphasis on the significance of quality road infrastructure investment. She added that replacing the bridges would make the highway more resilient to flood conditions.
