Intel has commenced a €5 billion ($5.7 billion) capital investment to upgrade its Irish campus and expand its European output. This will enable the company to the meet growing global demand for AI. Additionally, it will allow the company to meet demands for high-performance computing, the U.S. chipmaker said on Monday.

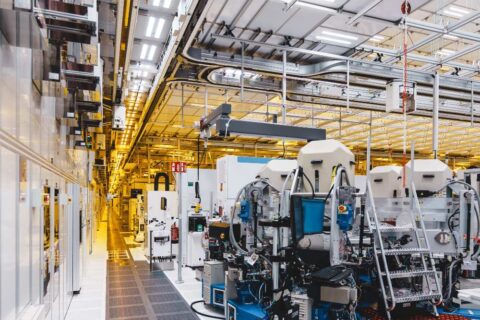

Intel stated that the move would upgrade and maximize capacity at its facility in Leixlip outside Dublin. This facility produces Intel 3 silicon wafers, which the company says is the most advanced semiconductor manufacturing facility of its kind in Europe.
Moreover, it will link the facility to other factories at the campus, Intel’s European manufacturing base. Also, it will link the facility to advance research and development and retrain staff, Naga Chandrasekaran, executive vice president of Intel Foundry, stated.
Intel is one of the key multinationals in Ireland’s foreign investment-focused economy. The company has already invested €30 billion in the country since 1989, more than half of which was spent between 2019 and 2023 on the fabrication facility that doubled the available capacity in Ireland.
Additionally, the leading-edge manufacturing equipment that Intel has started to install will help deliver Intel Xeon 6 processors. Also, it will help deliver next-generation Intel Xeon built on the group’s Intel 3 manufacturing process, the company said.
“The demand for servers, the demand for AI is driving a significant increase in the need for Intel 3 wafers,” Chandrasekaran told reporters.
Chandrasekaran said the investment would add “several hundred” more jobs to the 4,900 people Intel employs in Ireland.
The majority of the investment would be made by the end of 2027. It represents approximately 30% of Intel’s $17 billion planned capital expenditure for 2026, he added.

Other Companies Investment in Ireland
Ireland has set favourable policies that have attracted multinationals to set up factories in their soil. Other than Intel, companies such as Dexcom are also seeking to establish factories in Ireland in bid to expand their global footprint.
Significance of the Investment
Ireland is hugely reliant on the taxes and jobs of foreign multinationals such as Intel. Foreign-owned firms have almost doubled their Irish workforce in the last decade to make up 11% of the entire labour market.
Irish Prime Minister Micheal Martin said Intel’s latest investment was a powerful vote of confidence in Ireland and its position as a location for advanced manufacturing.
Intel’s Leixlip Campus: Project Factsheet
Core Project Name: Intel Fab 34 Expansion Project (plus subsequent facility upgrades)
Location: Leixlip, County Kildare, Ireland
Total Initial Capital Investment: €17 Billion (Initial construction of Fab 34)
Subsequent Expansion (Recent): €5 Billion ($5.7 Billion) added to maximize capacity, upgrade existing fabrication lines, and support tools for data center production.
Key Partners: Intel entered a joint investment partnership, selling a 49% minority stake in the Fab 34 joint venture to Apollo Global Management.
Main Contractor: Exyte
Technical Capabilities and Production
- Facility Size: 50,000 square meters (doubling Intel’s total manufacturing footprint in Ireland).
Process Nodes:
- Intel 4: The first facility in Europe to utilize Extreme Ultraviolet (EUV) lithography in high-volume manufacturing.
- Intel 3: Supporting production for the group’s foundry clients and advanced computing lines.
- Target Products: Intel Xeon 6 processors, next-generation Intel Xeon server chips, and advanced client processors (paving the way for AI infrastructure and AI PCs).
Timeline and Construction Milestones:
- 2019: Groundbroken and construction officially commenced on Fab 34.
- September 2023: Module 1 of Fab 34 officially opens, entering high-volume production on Intel 4 technology.
- Early 2025: Module 2 comes online and enters operational status.
- Present (Ongoing): Integration of advanced high-tech tools funded by the subsequent expansion, scaling up output for Intel Foundry customers.
Project Team
Exyte: Main Construction Contractor. Responsible for the complex high-tech facility design, cleanroom build-outs, and structural engineering of Fab 34.
Mercury Engineering: Lead Electrical Contractor. Handled the massive power infrastructure, substation engineering, and primary electrical grid hookups required to power the EUV systems.
Jones Engineering Group: Mechanical & Process Piping Contractor. Managed the complex process piping networks, ultra-pure water systems, and chemical delivery loops essential to semiconductor manufacturing.
Modula Electric: Modular Wiring Systems. Designed and supplied the automated, precast modular wiring infrastructure that slashed on-site labor installation times.
The McAvoy Group: Fast-track Modular Infrastructure. Partnered to deliver the “Eastlands” site infrastructure, managing logistics and office/welfare hubs to support up to 7,500 construction personnel during peak deployment.
