Last Updated: Sep 9, 2025
Home » Energy » Nuclear » Microsoft backed Orion Nuclear Fusion Power Plant in Washington to be completed in 2028

Microsoft backed Orion Nuclear Fusion Power Plant in Washington to be completed in 2028

Home » Energy » Nuclear » Microsoft backed Orion Nuclear Fusion Power Plant in Washington to be completed in 2028

The Orion Fusion Power Facility is under development in Chelan County, Washington, by Microsoft-backed nuclear fusion company, Helion. Microsoft, in May 2023, signed what it called the world’s first nuclear fusion power purchase agreement (PPA). Under the deal, the company will offtake up to 50 MW of capacity after a one-year ramp-up phase.

The plant is projected to begin supplying electricity to Microsoft’s data centers in the state by 2028, provided construction and testing progress as planned. The power needs for data centers around the country has aroused interest in nuclear power plants as a source of energy for grid stabilization. Even in North Dakota where fossil fuel is predominant, Nucleon Energy has been picked to lay groundwork for Nuclear Power Plan.

Reported on July 31 2025 – Washington-based fusion energy company Helion Energy has commenced construction on Orion, nation’s first commercial nuclear fusion power plant, cementing the state’s status as a clean energy innovation hub. The facility will be located in Chelan County, Washington. The site was selected due to its proximity to existing power transmission infrastructure and its decades-long legacy of energy innovation.

The revolutionary construction follows Helion’s record-breaking power purchase agreement (PPA) with Microsoft in 2023. Under the agreement, Helion will supply at least 50 megawatts of power from the Orion plant to Microsoft by 2028. Constellation Energy will serve as the project’s power marketer and will be tasked with feeding electricity into the grid.

“Today is a momentous day – not just for Helion, but for the entire fusion industry – as we unlock a new era of energy independence and industrial rebirth,” stated David Kirtley, Helion’s CEO and co-founder. “We have been singularly focused since the company was established on getting fusion technology ready for commercialization and putting electrons on the grid. Starting site work brings us one step closer to that dream.”

Microsoft also emphasized the importance of the collaboration in driving sustainable energy innovation. “Fusion represents an inspiring frontier in the world’s pursuit of clean and abundant power,” said Melanie Nakagawa, Chief Sustainability Officer and Corporate Vice President for Energy, Connectivity, and Sustainability at Microsoft. “While the path to commercial fusion is still unfolding, we’re proud to support Helion’s pioneering work here in Washington state as part of our broader commitment to investing in sustainable energy.”

Land Lease

The Orion Nuclear fusion power plant is being built in Malaga, Washington, on 20 acres leased from the Chelan County Public Utility District (PUD). The project underwent a Mitigated Determination of Non-Significance (MDNS) under the State Environmental Policy Act (SEPA) prior to construction. Helion has been engaging actively with state and local stakeholders—government agencies, Tribal Nations, and the community—since 2023 as part of its transparent planning and permitting process. That engagement will continue throughout construction.

Capacity

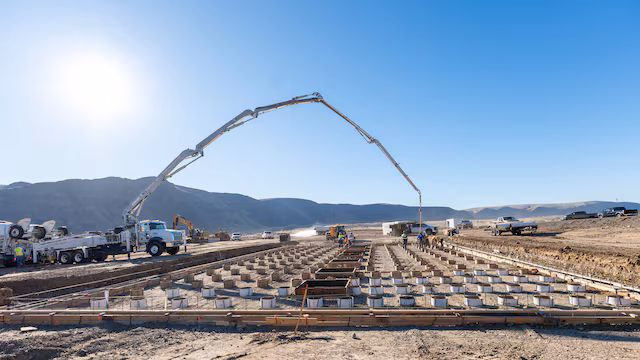

The plant is designed to provide 50 megawatts of power with the potential to scale to 100 megawatts in later stages. The first phase includes breaking ground and foundation work, followed by the installation of Helion’s proprietary fusion technologies. Once online, the Orion facility will connect into Washington’s primary power grid, delivering electricity upstream of Microsoft’s data centers.

Helion’s fusion method relies on rapid prototyping and internal innovation. Its seventh-generation prototype, Polaris, is expected to be the first to directly produce electricity from fusion. An earlier prototype, Trenta, was the first privately built fusion device to reach a fuel temperature of 100 million degrees Celsius—a milestone critical to enabling net energy production.

Orion is the first United States fusion power plant to break ground, a record in the commercialization of fusion energy.

Read also: Microsoft Invests in AtmosClear’s Carbon Capture Facility in Louisiana with World’s Largest Deal

Funding

The project has robust private funding backing. In January 2025, Helion raised $425 million in Series F funding from SoftBank Vision Fund 2 as the lead, bringing its total funding to over $1 billion. That followed a $500 million Series E in 2021 led by Sam Altman and joined by Mithril Capital, Capricorn Investment Group, Lightspeed Venture Partners, Dustin Moskovitz, and steelmaker Nucor. An additional $1.7 billion in capital has been committed pending future technical milestones.

With construction underway and grid delivery targeted for 2028, Helion remains on track to deliver fusion power to a commercial customer for the first time. As the project breaks ground in Washington, it represents a broader step toward unleashing fusion’s long-awaited potential to supply sustainable, high-yield energy for a carbon-free future.

Read also: Microsoft forced to Delay Major US$1 billion Data Center Expansion in Ohio

Orion Nuclear Fusion Power Plant in Washington – Project Factsheet

Project Overview

Developer: Helion Energy

Status: Under Construction (First U.S. commercial fusion plant to break ground)

Target Commercial Operation: 2028

Location & Site Details

Location: Malaga, Washington (Chelan County)

Site Area: 20 acres

Land Arrangement: Leased from Chelan County Public Utility District (PUD)

Site Selection Rationale: Proximity to existing power transmission infrastructure and regional energy innovation legacy

Technical Specifications

Initial Capacity: 50 megawatts

Future Expansion Potential: 100 megawatts

Technology: Proprietary fusion technology with rapid prototyping approach

Grid Connection: Washington’s primary power grid

Commercial Agreement

Primary Customer: Microsoft Corporation

Power Purchase Agreement (PPA): Minimum 50 MW delivery by 2028

Power Marketer: Constellation Energy

Agreement Date: 2023
