Last Updated: Oct 17, 2025
Home » Energy » LNG » Inside NextDecade’s $6.7B Train 4 at Rio Grande LNG — Funding, EPC Contract, and Construction Timeline

Inside NextDecade’s $6.7B Train 4 at Rio Grande LNG — Funding, EPC Contract, and Construction Timeline

Home » Energy » LNG » Inside NextDecade’s $6.7B Train 4 at Rio Grande LNG — Funding, EPC Contract, and Construction Timeline

In September 2025, NextDecade Corporation made a final investment decision (FID) and achieved financial close for Train 4 of the Rio Grande LNG export terminal in Brownsville, Texas, marking another major phase in the multibillion-dollar project’s build-out. The company also issued a full notice to proceed to Bechtel Energy, authorizing the start of construction.

Valued at approximately $6.7 billion, Train 4 adds about 6 million tonnes per annum (MTPA) of liquefied natural gas capacity, bringing total output under construction to roughly 24 MTPA. The expansion is underpinned by 20-year sales and purchase agreements with ADNOC, TotalEnergies, and Aramco, with completion and first commercial deliveries anticipated in the second half of 2030.

Funding for Train 4 combines $3.85 billion in debt and $2.83 billion in equity from NextDecade, Global Infrastructure Partners (a BlackRock company), GIC, Mubadala Investment Company, and TotalEnergies. NextDecade’s share of equity was financed through term loans without diluting common share

Meanwhile, on October 16, 2025, NextDecade made a positive FID on Train 5, closed financing for the train, and issued a full notice to proceed to Bechtel Energy for EPC work — advancing the next phase of the Rio Grande LNG expansion.

Equity commitments from TotalEnergies and GIP

In August 2025, NextDecade Corporation announced that it had secured up to $1.8 billion in new equity commitments from TotalEnergies and Global Infrastructure Partners (GIP) to support the development of Train 4 at the Rio Grande LNG export terminal in Brownsville, Texas. The investment marked a key step toward advancing the next phase of the multibillion-dollar liquefied natural gas project.

Under the agreement, TotalEnergies will invest about $300 million for a 10% stake in the Train 4 joint venture, while a GIP affiliate will contribute up to $1.5 billion for a 50% interest, which will fall to 30% once certain return thresholds are met. NextDecade, through its subsidiaries, will provide up to $1.2 billion for a 40% share, which could increase to 60% after GIP reaches agreed returns.

Train 4 will have a capacity of 5.4 million metric tons per annum (MTPA) and is awaiting a final order from the Federal Energy Regulatory Commission (FERC). The regulator has completed its environmental review, and staff recently recommended the project be approved.

Construction of Train 4 will be carried out under a $4.77 billion fixed-price, turnkey engineering, procurement, and construction (EPC) contract with Bechtel Energy Inc., awarded in June and valid through September 15, 2025. NextDecade is also developing Train 5, backed by a $4.32 billion EPC contract with Bechtel, and is working to secure additional long-term LNG sales to reach a final investment decision.

Once complete, the Rio Grande LNG facility will have 17.6 MTPA of capacity, with Trains 4 and 5 adding a further 10.8 MTPA, reinforcing the U.S. position as the world’s top LNG exporter.

Read also: Texas Approves $216M Loan for NRG’s 456 MW Natural Gas Plant in Houston

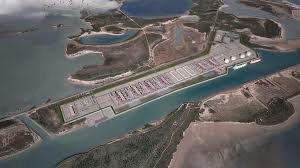

Train 4 at Rio Grande LNG
Train 4 at Rio Grande LNG

Rio Grande LNG Expansion Project Factsheet

Project Overview

Company: NextDecade Corporation

Project: Rio Grande LNG facility expansion with Trains 4 and 5

Location: Texas, United States

Total Facility Capacity: 17.6 million tonnes per annum (MTPA)

Additional Capacity from Expansion: 10.8 MTPA (Trains 4 & 5)

Read also: Enbridge Commits $900M to 600 MW Clear Fork Solar Project in Texas to Power Meta’s Data Center

Key Financial Commitments

Construction Contracts

Total EPC Contract Value: $9.09 billion with Bechtel Energy Inc.

Train 4: $4.77 billion (fixed-price, turnkey)

Train 5: $4.32 billion (fixed-price, turnkey)

Contract Price Lock: Until September 15, 2025

Additional Costs per Train: $1.8–$2.0 billion (owner’s costs, contingencies, financing)

New Equity Financing for Train 4

Total Equity Commitments: Up to $1.8 billion

TotalEnergies: $300 million for 10% stake

Global Infrastructure Partners (GIP): Up to $1.5 billion for 50% stake (reducible to 30%)

NextDecade: Up to $1.2 billion for 40% stake (expandable to 60%)

Commercial Agreements

Train 4

All capacity contracted under long-term agreements

Includes LNG supply deal with TotalEnergies

Train 5

JERA Contract: 20-year agreement for 2 million tonnes per year

Remaining Capacity: 2.5 million tonnes seeking additional buyers for financing support

Project Status & Timeline

Regulatory Approval

FERC Environmental Review: Completed for Train 4

Development Phase

Financing processes initiated for both trains

Target: Final investment decisions before September 15, 2025 contract deadline

Key Partners

EPC Contractor: Bechtel Energy Inc.

Major Investors: TotalEnergies, Global Infrastructure Partners

Commercial Partners: TotalEnergies, JERA

Regulatory Authority: Federal Energy Regulatory Commission (FERC)

Read also: Texas Approves First $105M Loan for Natural Gas Plant Under New Energy Fund
