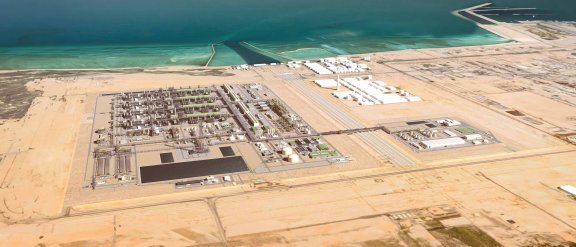

The North Field East LNG Project in Ras Laffan, Qatar, continues to advance toward its revised 2027 completion target following a period of construction disruption triggered by the regional conflict that began in February 2026. Japanese engineering giant Chiyoda Corporation and Technip Energies have since remobilised personnel, allowing the Chiyoda Technip Joint Venture (CTJV) to resume onshore work on what ranks among the largest LNG developments ever undertaken. QatarEnergy LNG awarded the project in February 2021, with a total development cost of approximately US$28.75 billion and an onshore engineering, procurement, construction and commissioning (EPCC) contract valued at about US$13 billion.
The project covers four mega LNG trains, each with an individual capacity of 8 million tonnes per annum (MTPA), adding approximately 32 MTPA of new LNG production. Once completed, the expansion will increase Qatar’s overall LNG production capacity from 77 MTPA to 110 MTPA. The development spans a massive plant footprint and is expected to mobilise more than 45,000 workers at peak construction.
Construction followed the February 2021 final investment decision, with QatarEnergy initially targeting first LNG production around mid-2026. Regional disruptions in February 2026 interrupted the construction programme and pushed the schedule back, with the first NFE train now expected to begin commercial LNG production in 2027. The remaining trains will follow as commissioning progresses across the expanded Ras Laffan complex.
Technology licensor Air Products and Chemicals supplies the proprietary AP-X liquefaction process for the project. QatarEnergy LNG remains the asset owner and project client, overseeing the development alongside Qatar’s energy authorities. The NFE expansion also forms the first major stage of Qatar’s broader North Field growth strategy, which includes the subsequent North Field South and North Field West developments.

Gulf Ambitions, Tested and Intact
The suspension and now restart of the North Field East project underscores just how exposed mega LNG developments can be to geopolitical shock, but also how quickly confidence can return when diplomatic conditions shift. The US-Iran ceasefire in April 2026 opened the window for contractors to consider remobilisation, and Chiyoda’s confirmation of a full return to Ras Laffan is the clearest signal yet that the Gulf LNG expansion programme remains fundamentally intact.
The broader North Field programme, which also includes the North Field South and North Field West phases targeting a combined capacity increase from 77 to 142 MTPA by 2030, represents the most ambitious liquefaction buildout in the world. For context, the US LNG sector, dominated by Cheniere’s Sabine Pass with individual trains rated at roughly 5 MTPA, simply cannot match the unit scale Qatar achieves through the AP-X process. That scale advantage, with capital costs estimated in the US$800 to US$900 per tonne per annum range, is far below the US$1,500 per tonne seen at recent American developments.
The NFE project will also lift Qatar’s total export capacity from 77 to 110 MTPA. Chiyoda’s track record is central to understanding why CTJV was the natural choice: the company has participated in all fourteen LNG train series constructed in Qatar, executing EPC work across twelve of them. That institutional depth, combined with Technip Energies’ engineering and commissioning expertise, gives QatarEnergy a contractor pairing with few credible equals on a project of this complexity. Parallel investment is also continuing across Qatar’s downstream energy infrastructure, including the recently awarded Laffan Refinery 1 upgrade contract, reinforcing how the country is simultaneously expanding LNG export capacity while modernising its refining and processing assets at Ras Laffan.
Additionally, the progress of North Field East also highlights the scale of LNG developments moving through different stages of the global project pipeline. While Qatar’s NFE expansion has advanced into construction and targets 2027 completion, Papua LNG in Papua New Guinea is approaching its own major investment milestone, with the project moving toward a Final Investment Decision. The contrast reflects continued investment in large-scale LNG infrastructure as developers seek to bring new gas supply to international markets. Papua LNG’s expected FID would move the US$12 billion-plus development from its preparation and evaluation phase into the next stage of project execution, positioning it as another major LNG project to watch as global capacity expands.

Project Fact Sheet
- Project: North Field East (NFE) LNG Expansion Project
- Location: Ras Laffan Industrial City, Qatar
- Project Value: Approximately US$28.75 billion total development cost; US$13 billion onshore EPCC contract
- Client/Owner: QatarEnergy LNG
- Scope of Work: Engineering, Procurement, Construction and Commissioning (EPCC) of four LNG mega trains and associated utility and offsite facilities
- LNG Capacity: 4 trains x 8 MTPA = 32 MTPA total; increasing Qatar’s export capacity from 77 to 110 MTPA
- Technology Licensor: Air Products and Chemicals (AP-X liquefaction process)
- Plant Area: 2,698,000 m2
- Feed Gas Input: Approximately 6 billion standard cubic feet per day from Qatar’s North Field
- Environmental Feature: Integrated CO2 Carbon Capture and Sequestration (CCS) facility targeting more than 25% reduction in greenhouse gas emissions versus comparable LNG plants
- Peak Workforce: Over 45,000 workers at peak construction
- Construction Status: Fully resuming May 2026 following suspension caused by Iran conflict; first train startup revised to early 2027; full sequential commissioning targeted by mid-2028
Project Team
- Client/Owner: QatarEnergy LNG (subsidiary of QatarEnergy, Qatar’s state energy company)
- EPCC Joint Venture (CTJV): Chiyoda Corporation (Japan) and Technip Energies (France)
- Offshore Contractor: McDermott International (wellhead topsides, subsea pipelines and cables, onshore pipeline scope)
- Offshore EPCI Contractor: Saipem (Italy) — North Field Production Sustainability Offshore Compression Complexes, multiple packages under execution
- Regulatory Authority: Qatar Ministry of Energy and Industry
- International Equity Partner: Sinopec (China) — 1.25% stake in NFE project (equivalent to 5% in one train)
- LNG Offtake Partners: Sinopec (China), Germany (via long-term supply agreements commencing 2026)
